The US Nuclear Regulatory Commission issued a construction permit for the Tennessee Valley Authority’s Clinch River BWRX-300 on 29 September 2026, 447 days after the staff accepted the application on 9 July 2025. The staff’s own schedule letter of 25 July 2025 placed the final safety evaluation in November 2026. It was signed on 25 June 2026. The environmental review kept its planned month, so the gain sits in the safety track, compressed by four to five months. A permit is still not a build: the IAEA reactor database, last updated 16 July 2026, lists no US reactor under construction.
Clinch River construction permit timeline
TVA filed the environmental report on 28 April 2025 and the preliminary safety analysis report on 20 May 2025, after pre-application engagement that ran from February 2022 to April 2025. The mandatory hearing took place on 13 August 2026, post-hearing comments closed on 28 August, and the permit followed 32 days later. From the final safety evaluation to the permit took 96 days.
The NRC environmental statement describes the unit as about 870 MWt with a nominal gross output of 300 MWe. That implies a gross thermal efficiency of 300 / 870 = 34.5 percent, within the range expected of a light water reactor and consistent with 300 MWe being a gross, not net, figure. TVA holds a 2019 early site permit for the site, and the NRC states that a separate operating license is required before operation.

NRC review schedule versus actual dates
The table sets the milestones in the NRC’s July 2025 schedule letter against the dates on the NRC project page. Margins are computed from the first and last day of the planned month.

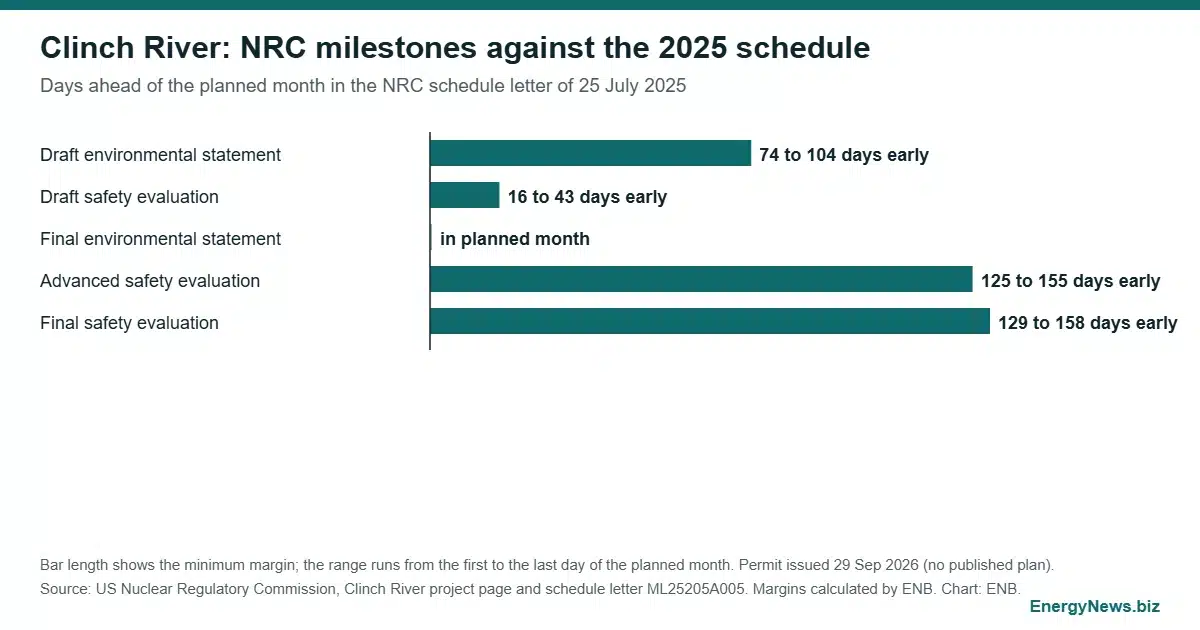

| Milestone | Planned (letter of 25 July 2025) | Actual | Margin |
|---|---|---|---|
| Draft supplemental environmental impact statement | December 2025 | 18 September 2025 | 74 to 104 days early |
| Draft safety evaluation | February 2026 | 16 January 2026 | 16 to 43 days early |
| Final supplemental environmental impact statement | April 2026 | 6 April 2026 | in planned month |
| Advanced safety evaluation | October 2026 | 29 May 2026 | 125 to 155 days early |
| Final safety evaluation | November 2026 | 25 June 2026 | 129 to 158 days early |
The pattern is specific. The environmental track ran roughly to plan. The safety track, which the staff had scheduled over nine months from the draft to the final evaluation, was done in just over five.
Is the four months ahead claim accurate
The NRC chairman called the outcome four months ahead of schedule. The final safety evaluation margin of 129 to 158 days, or 4.2 to 5.2 months, supports that figure at the staff level. The decision date itself cannot be rebuilt from the letter, because it states that the schedule excludes the hearing process. The four months at the permit stage therefore rests on a baseline the NRC has not published in the documents reviewed here.
NRC staff hours for the Clinch River review
A revised schedule letter moved the final safety evaluation from November 2026 to 30 June 2026 and cut the staff effort estimate from 25,000 hours to 16,500 hours. The reduction is 8,500 / 25,000 = 34 percent. Contractor support stayed at $1.4 million. The NRC attributes the change to collaboration with TVA and streamlined review. These are planning estimates, not audited actuals, but they give other applicants a measurable benchmark.
Darlington licence to construct comparison
The Canadian regulator offers the only operating reference for the same design. Ontario Power Generation applied for a licence to construct in October 2022, the Commission held hearings on 2 October 2024 and 8 to 14 January 2025, and the licence was issued on 4 April 2025, about 30 months after application, according to the CNSC project timeline. TVA’s permit took 17 months from its first submission. The two are not like for like: Ontario Power Generation held a site preparation licence from 17 August 2012, TVA an early site permit from 2019, and the procedures differ. Read the 13 month gap as an order of magnitude, not a ranking. The cost side of the same design is covered in ENB’s look at the BWRX-300 European fleet plan.
SMR under construction versus permitted
The IAEA PRIS table, updated 16 July 2026, counts 77 reactors and 80,720 MW under construction in 17 countries. Canada has one unit of 300 MW, 0.4 percent of that capacity, and the United States has none. The Canadian regulator reports one BWRX-300 under construction at Darlington, with its first regulatory hold point removed on 30 March 2026 and an operating licence application filed on 25 March 2026. Capacity basis needs care: the NRC figure is gross, and the database page does not state its basis.
The NRC release and the environmental statement give no construction start date for Clinch River, so a US entry in the database depends on construction actually beginning. The next measurable test of the new pace is the two unit SMR-300 application for Palisades in Michigan: Part 1 was filed on 31 December 2025, docketed on 27 February 2026, and a receipt notice appeared in the Federal Register on 1 October 2026.
